Drilling and operations

Drilling the deep geothermal well at Eden

The Eden well is called EG-1 and was drilled in sections.

Eden Geothermal Phase One wellbore diagram

The conductor section was drilled before the main rig arrived, as part of the site completion. It’s a larger (34” – 36”) hole, which was drilled through the looser, weathered ground near the surface, until we reached competent bedrock, at 32m. Wide diameter steel conductor pipe was then cemented into place, to seal off the start of the well from any looser, softer ground and to form a stable start collar or ‘foundation’ for drilling.

The first section to be drilled by the main rig was the 26” section, between 32m and 240m. We used two 26” drill bits, weighing 630kg each to get to 240m. (The granite at Eden is extremely hard, so after a certain number of rotations, the bits become worn and must be replaced.) Then the drillstring was ‘tripped out’ (pulled out) of the well and this section was lined with 20” steel casing, which was subsequently cemented into place using specialist cement.

Next, the 17 ½” section was drilled, using eight 17 ½” bits. When this section was completed, at 1510m, the process of ‘tripping out’ of the well and ‘running’ and cementing casing  – this time 13 ⅜” diameter – was repeated.

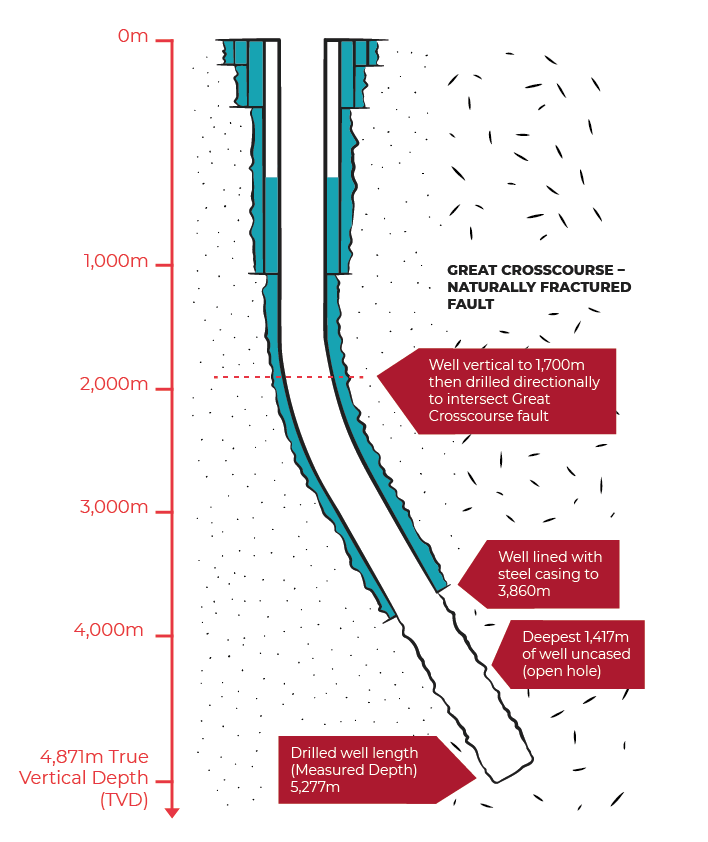

The 12 ¼” section is the longest section of the well. At 1706m we “kicked off”: that is, the well started to be drilled directionally, deviating east away from the vertical and towards the target zone in the Great Crosscourse fault. Now that we’re drilling directionally, the measured depth (MD) of the well – its total length from start to end – starts to become greater than its total vertical depth (TVD) – the vertical distance from the well surface to the deepest point.

The 12 ¼” well section was cased just before 4000m MD.

An 8 ½” drill bit was used to drill the 8½” diameter section, which is open-hole (i.e. not cased) for the last 1,417m of the well.

Drilling took 162 days, finishing in October 2021, and the completed well is 4, 871m TD (total depth) and 5,277m MD, making it the longest geothermal well in teh UK.
